Power Has Become the Primary Constraint on Hyperscale Growth

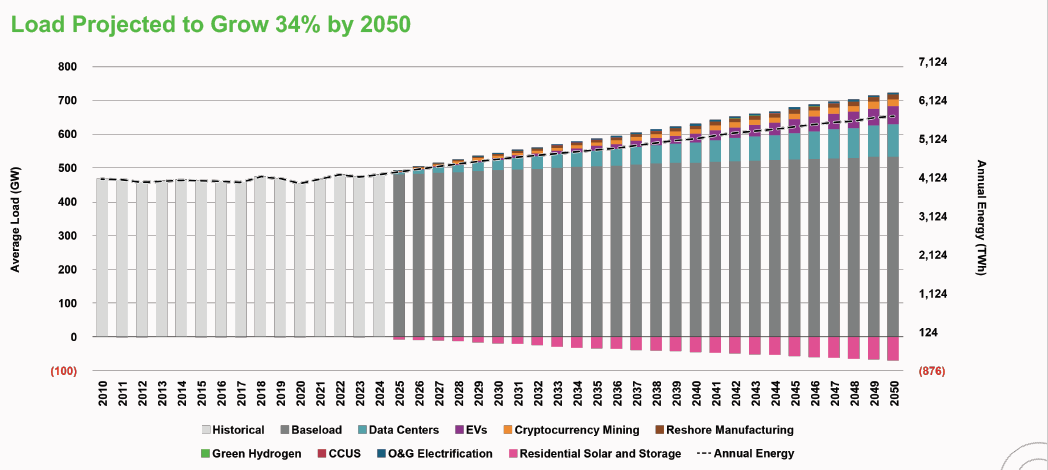

Hyperscalers are entering the largest capital deployment cycle in the history of the technology sector. AI-driven workloads are accelerating data center development at unprecedented speed. As cited in a recent pv magazine article, Enverus Intelligence Research (EIR) projects U.S. electricity demand will rise 34% by 2050.

Data Centers and EVs Power New Wave of Load

Figure 1. image source: Enverus Intelligence® Research, EIA, National Weather Service, Census Bureau, NASA

Yet compute is no longer the bottleneck.

Power is.

Across the U.S., grid expansion timelines, interconnection backlogs, and transmission constraints are colliding with hyperscaler demand. This growing disconnect between demand and deliverable capacity is reshaping how hyperscalers approach site selection and growth.

In response, hyperscalers are no longer waiting for the grid to catch up. They are actively securing power certainty themselves.

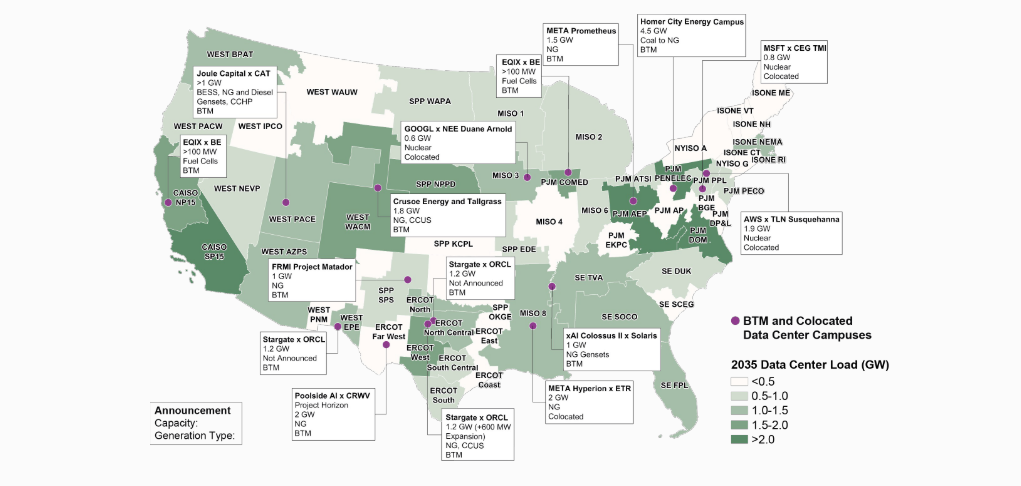

Big Tech Pivots to Over 40GW of BYOG

Enverus Intelligence® Research, Enverus PRISM® Load Tracking Analytics, company disclosures
Figure 2. image source: Enverus Intelligence® Research, Enverus PRISM® Load Tracking Analytics, company disclosures

This map shows more than 40 GW of behind-the-meter and colocated generation announced by hyperscalers. This expansion into self-supplied power reflects the growing constraint on grid-connected capacity.

The Layers of Today’s Power Constraints

Regional Capacity Limits Are Emerging

Not all data center markets offer the same ability to scale.

Some regions still have meaningful headroom. Others appear attractive on the surface but are already constrained once existing capacity, queued projects, and future load growth are considered.

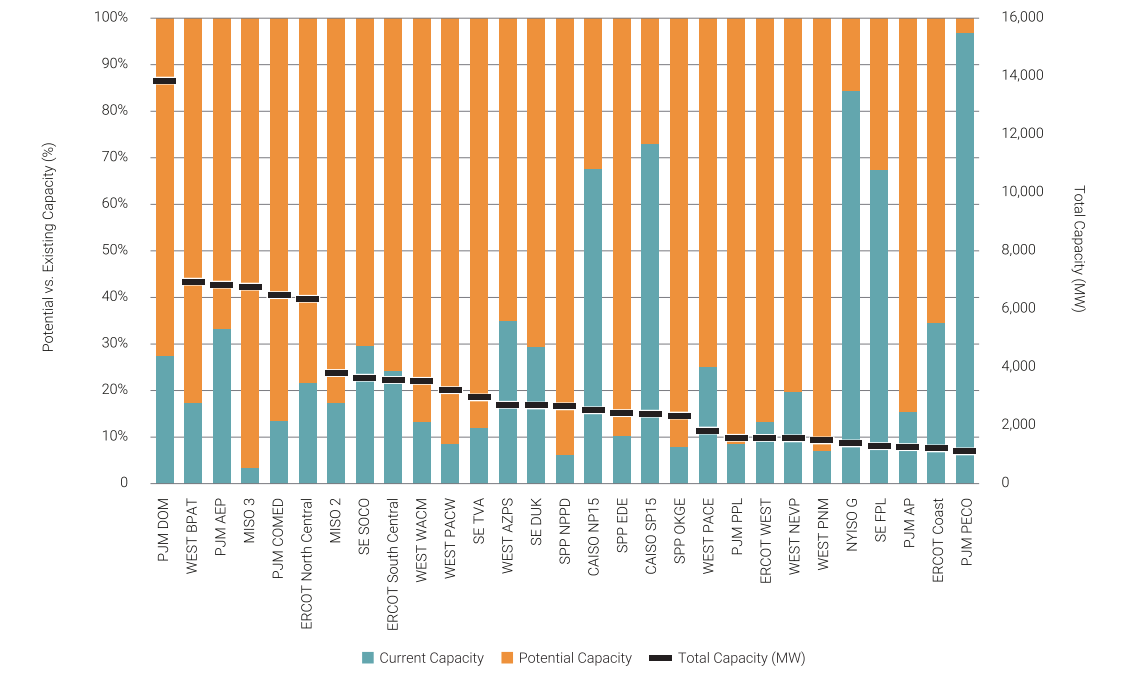

Current vs. Future Capacity

Enverus Intelligence® Research, Enverus FOUNDATIONS® - Power & Renewables, Enverus Load Tracking Analytics
Figure 3. image source: Enverus Intelligence® Research, Enverus FOUNDATIONS® – Power & Renewables, Enverus Load Tracking Analytics

This view highlights how quickly available data center capacity is being consumed in several marquee markets. For hyperscalers, the critical question is no longer Is there power today? but:

Can this market support multi-phase expansion without hitting structural limits?

Site-Level Deliverability Determines What’s Actually Buildable

Even in markets that appear scalable, not every site can deliver. Interconnection queues continue to grow, but queue size alone does not determine whether a project will succeed. Deliverability depends on:

In many cases, power that looks available on paper becomes constrained once large-scale deployment begins. A recent example highlights this risk: in West Jefferson, Ohio, a planned $1 billion data center project was canceled after developers determined that local grid limitations could not support the facility without overloading infrastructure. That is why granular infrastructure analysis and early site positioning are critical.

Enverus PRISM® visualization of substation-level injection and withdrawal capacity within PJM
Figure 4. image source: Enverus PRISM® visualization of substation-level injection and withdrawal capacity within PJM

Even when hyperscalers bring their own power or co-locate generation, which improves speed to power and cost control, it does not eliminate dependency on surrounding transmission and substation infrastructure. Self-supplied sites still operate within the limits of transmission topology, substation design constraints, and evolving congestion in the surrounding network.

Enverus PRISM® visualization of operating and planned transmission lines in Texas
Figure 5. image source: Enverus PRISM® visualization of operating and planned transmission lines in Texas

By tracking renewable, storage, and generation projects from development through operation, Enverus helps teams identify where congestion and infrastructure pressure will emerge, often well before those constraints appear in ISO reports.

The Hidden Competition for Scalable Power

One of the least visible dynamics in hyperscale expansion is how early a small number of players move to secure future power. Long before a data center is publicly announced:

By the time a market appears “open,” much of the scalable power may already be spoken for, and without the right intelligence, it’s difficult to see how much headroom is truly left.

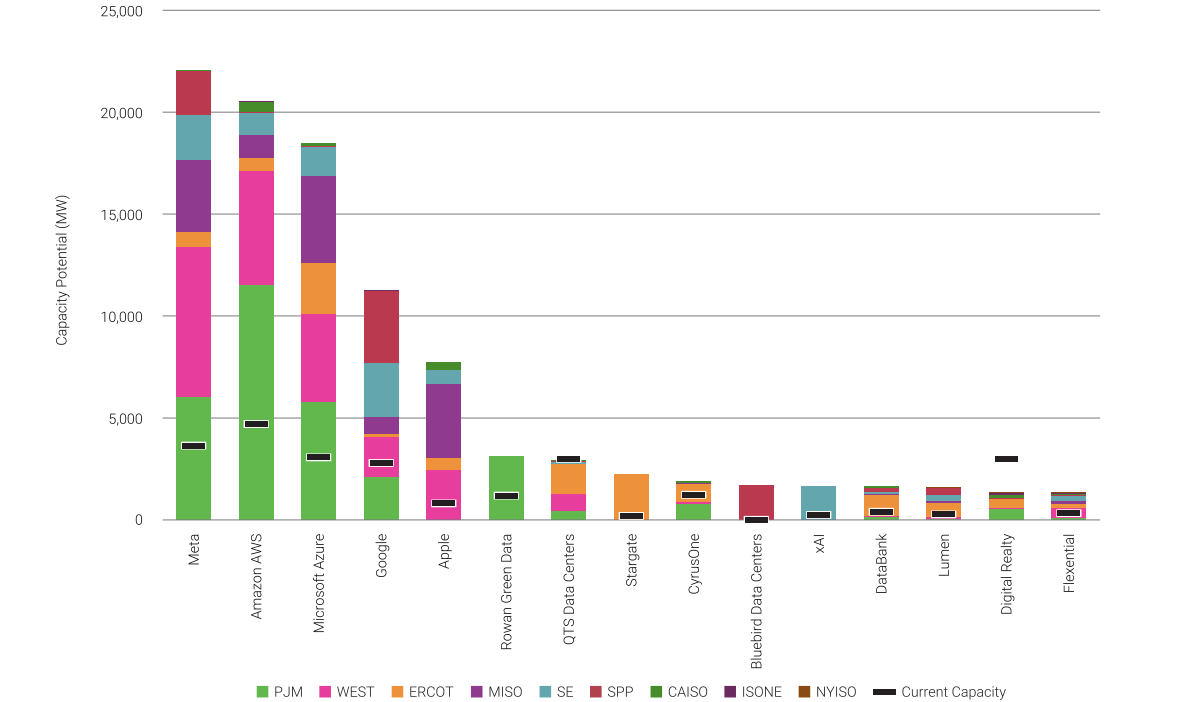

Capacity Potential by Developer, Grouped by ISO

Enverus Intelligence® Research, Enverus FOUNDATIONS® - Power & Renewables, Enverus Load Tracking Analytics
Figure 6. image source: Enverus Intelligence® Research, Enverus FOUNDATIONS® – Power & Renewables, Enverus Load Tracking Analytics

The visualization above shows how hyperscalers already control large portions of future capacity potential in key ISOs, intensifying competition for the remaining headroom.

The Framework for Achieving Power Certainty at Scale

Securing power at scale requires more than reacting to market signals. By the time constraints become visible, early movers have already positioned themselves for growth. Power certainty comes from knowing:

Successful hyperscale expansion relies on a few core practices:

The common factor is clear insight into how the grid is structured today and how it will evolve as new load and generation come online.

Amazon | Southeast of Louisa, Virginia – 1,068 Buildable Acres, 1.9GW

Enverus Intelligence® Research, Enverus FOUNDATIONS® - Power & Renewables, Enverus Load Tracking Analytics
Figure 7. image source: Enverus Intelligence® Research, Enverus FOUNDATIONS® – Power & Renewables, Enverus Load Tracking Analytics

These parcel and infrastructure views help teams identify buildable opportunities aligned with viable substations, available capacity, and long-term expansion potential.

The New Rule: Demand Must Follow Power

The traditional assumption that power would follow demand no longer holds. In today’s environment:

The organizations that win are the ones that understand where power is real, where constraints will intensify, and how to preserve optionality before others see the opportunity. That is why teams rely on Enverus to understand where scale is physically possible and where the limits will form next.

About Enverus Intelligence® | Research, Inc. (EIR)

Enverus Intelligence® | Research, Inc. (EIR) is a subsidiary of Enverus that publishes energy-sector research focused on the oil, natural gas, power and renewable industries. EIR publishes reports including asset and company valuations, resource assessments, technical evaluations, and macroeconomic forecasts and helps make intelligent connections for energy industry participants, service companies, and capital providers worldwide. See additional disclosures here.

Let’s get started!

We’ll follow up right away to show you a quick product tour.

Let’s get started!

We’ll follow up right away to show you a quick product tour.

Ready to Subscribe?

Ready to Get Started?
