Accelerating Solar & Storage Siting

Insights From a Multi‑Site Case Study in Indiana

Identify grid ready, commercially viable hybrid development locations faster

Solar and storage development is increasingly constrained by interconnection congestion, land scarcity, and capital discipline, making early, high confidence siting decisions critical. This case study demonstrates how Enverus PRISM®, RatedPower, and Pearl Street Interconnect enable developers to rapidly identify and prioritize high quality hybrid opportunities by unifying interconnection economics, land viability, pricing fundamentals, and competitive dynamics into a single, analytics driven workflow.

Using Indiana as a representative market, this analysis highlights how developers can move faster and with greater certainty by focusing capital on sites with manageable upgrade costs, scalable land positions, and durable hybrid economics. The workflow surfaces locations that support near term generation feasibility, long term storage value, and phased hybrid development while reducing development risk and avoiding oversubscribed interconnection points.

Solar Hero Image

Executive Summary

This case study illustrates how Enverus solutions help developers identify and differentiate solar and storage siting opportunities in Indiana by integrating interconnection cost signals, land buildability, pricing dynamics, and competitive pressure into a single decision framework.

Across three evaluated locations, the analysis reveals material differences in site quality driven by:

  • The cost and complexity of upgrading the grid to support incremental capacity
  • The level of planned generation competing for the same interconnection point
  • The quantity and contiguity of buildable land available for development
  • Longterm energy and intraday price signals supporting storage value
  • Modeled solar capacity achievable on buildable parcels

Among the sites evaluated, Miami County emerges with the best possible site. It offers the lowest upgrade costs, best land buildability, and minimal queue competition. Pike and Vermillion counties present viable but more specialized opportunities, each requiring more targeted hybrid or storage forward development strategies to interconnection and land constraints.

Evaluation Framework

Sites were evaluated using Enverus PRISM®, Interconnect, and RatedPower across the following criteria:

  • Proximity to transmission substations and associated voltage levels
  • Available injection in DPP2026, modelled network upgrade costs ($/MW), and the number of binding interconnection constraints
  • Existing and planned competitive generation capacity at the point of interconnection
  • Parcel level land availability and buildability
  • Historical and forward looking locational marginal price (LMP) trends and intraday spreads
  • RatedPower parcel level design outputs estimating achievable solar capacity on buildable acreage

By replacing fragmented datasets and manual screening with a unified analytics workflow, Enverus enables developers to reduce siting risk, prioritize capital efficiently, and advance projects with greater confidence earlier in the development lifecycle.

Challenges

Developers pursuing utility scale solar + storage projects in Indiana face a familiar challenge: identifying locations that simultaneously offer manageable interconnection economics, sufficient buildable land, and durable long term value. With most attractive substations already constrained, success increasingly depends on understanding where upgrades are economically viable and how hybrid configurations can unlock value despite limited injection availability.

The goal of this analysis is to identify high quality hybrid development zones where interconnection upgrades are justified by land scale, pricing fundamentals, and storage driven value stacking.

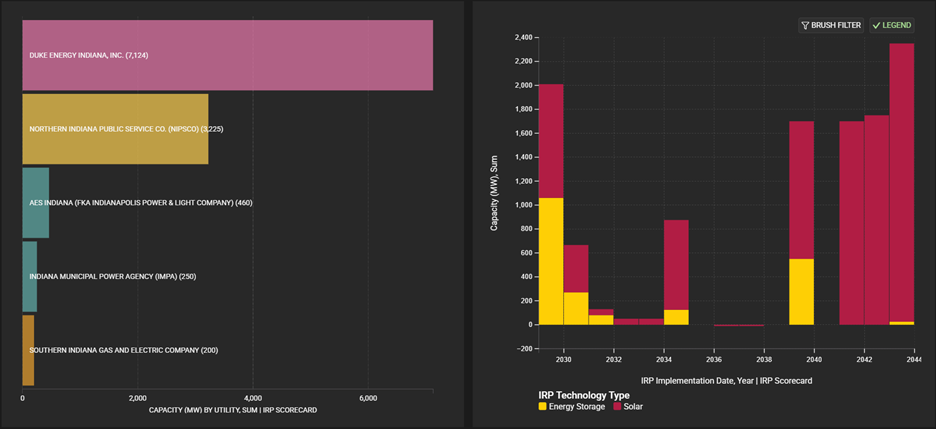

Market Opportunity

Indiana is a high value region for solar + storage development. Utilities across the state have outlined aggressive renewable and storage additions in recent Integrated Resource Plans, signaling sustained procurement needs. At the same time, the state is preparing for significant load growth from data centers, manufacturing expansions, and other power intensive industries. For example, Duke Energy Indiana has over 5,000 MWs of planned load capacity.

This convergence of renewable expansion, storage integration, and accelerating demand positions Indiana as an attractive market for developers who can move quickly and secure economically viable interconnection points. PRISM, RatedPower, and Interconnect compress months of manual screening into minutes, enabling that speed.

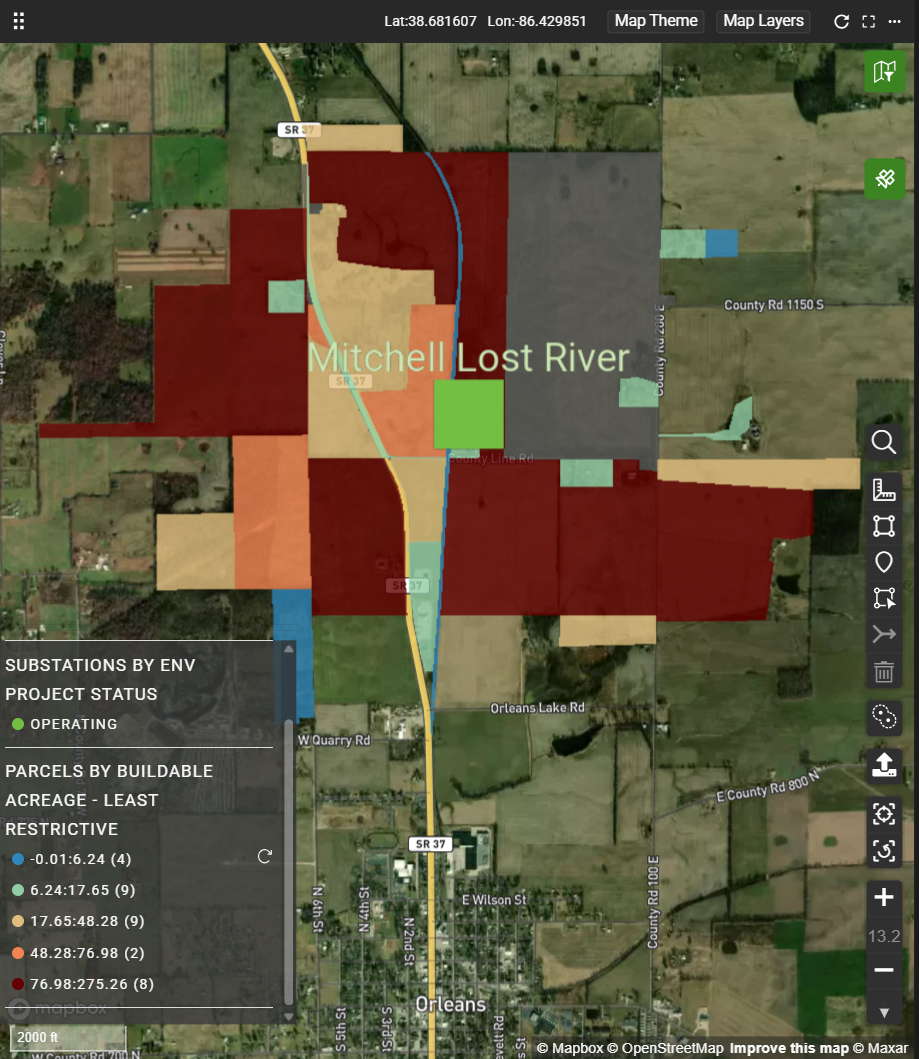

Project 1 – Pike County, Indiana

Attribute
Value
County
Pike
ISO
MISO
Nearest Substation
Petersburg Generating Station
Bus Voltage (kV)
345 kV
$/MW to Upgrade Site for 500MW Facility
$638,721
$/MW for Pre-Overloaded Network Upgrades
$408,309
$/MW for Newly-Overloaded Network Upgrades
$230,412
Number of Constraints for 500MW Facility*
6
Planned Capacity at Substation (MW)
100 MW
Adjacent Acreage (1-mile radius)
1,890 acres
Buildable Acreage
717 acres
LMP Node (Nearest to Site)
HE.RATTS.ARR-MISO-LMP
Avg. LMP, 5-Year Historical
$42.91/MWh
Avg. Solar-Weighted LMP, 5-Year Historical
$47.41/MWh
Avg. Top/Bottom 4-Hour Spread, 5-Year Historical
$30.48/MWh
Avg. LMP, 20-Year Forecast
$43.13/MWh
Avg. Solar-Weighted LMP, 20-Year Forecast
$38.53/MWh
Avg. Top/Bottom 4-Hour Spread, 20-Year Forecast
$31.32/MWh
Avg. PV RatedPower MWac per Parcel (MW)
8.10 MW
Avg. PV RatedPower MWac, Sum All Parcels (MW)
121.8 MW
$/MW to Upgrade Site for 122MW Facility
$2,617,709

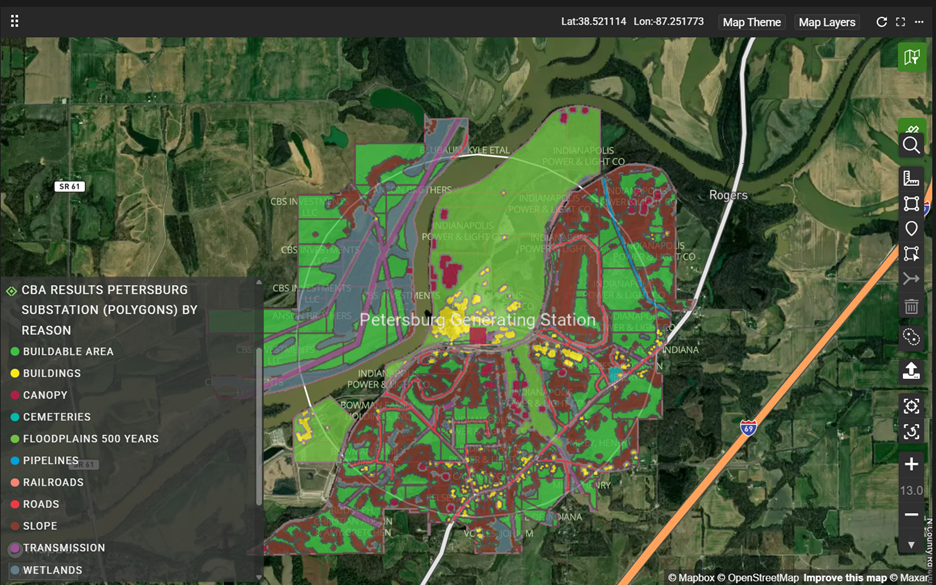

Opportunity Summary:

Petersburg is Indiana’s most de-risked development environment for utility-scale solar. The substation anchors a proven 345 kV node where three large projects are already operational, establishing clear precedent for permitting, landowner engagement, and construction execution. Pike County carries no county-level zoning ordinance, eliminating the regulatory friction that has derailed projects across 72 of Indiana’s 92 counties. Local officials have publicly welcomed renewable investment, and no organized opposition exists.

The principal constraint is economics: at $638,721/MW across 6 binding constraints, Petersburg carries the highest network upgrade cost in the evaluated set. A 500 MW facility would require approximately $319M in network upgrades, a significant capital burden that must be weighed against the site’s regulatory and execution advantages. The buildable footprint at 717 acres is also the smallest evaluated and will require multi-landowner assembly for a project of scale. A project fitting on this land, roughly 122MWac, would increase network upgrade cost exposure to $2,617,709. CCR contamination from the legacy coal plant imposes buffer requirements on adjacent parcel development.

Strengths

  • Three large solar projects already operational at the same substation complex (AES 250 MW + Arevon 192 MW Ratts 1 + Heirloom) — the development pathway is proven
  • Coal retirement context: legacy 345 kV transmission infrastructure originally sized for large thermal loads, now available for renewable interconnection
  • Explicit community and county support — county officials publicly welcomed investment; no organized opposition
  • Modest planned competition (100 MW), the lowest among evaluated sites

Challenges

  • Highest modelled upgrade costs with $638k per MW to upgrade for a 500 MW project, requiring clearance across 6 constraints, and over $2.6M per MW for the 122MW facility that the available land can support.
  • Smaller near-term buildable land footprint (~966 acres) relative to Miami County; may require landowner assemblies for large-scale expansion
  • CCR legacy at plant site requires maintaining appropriate buffer distance from the ash pond footprint for any adjacent parcel development
  • Coal-transition community dynamics may require thoughtful stakeholder engagement for project-specific outreach

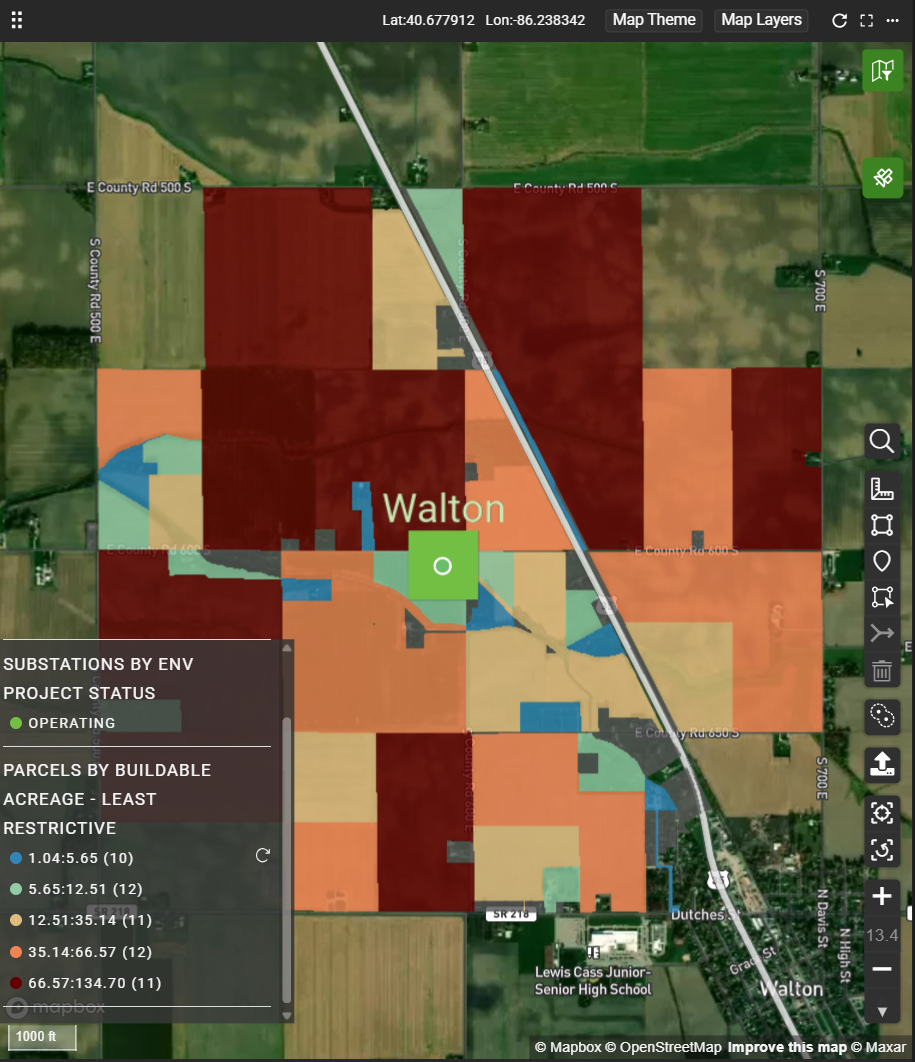

Project 2 – Miami County, Indiana

Attribute
Value
County
Miami
ISO
MISO
Nearest Substation
Deedsville
Bus Voltage (kV)
345 kV
$/MW to Upgrade Site for 500MW Facility
$188,100
$/MW for Pre-Overloaded Network Upgrades
$86,040
$/MW for Newly-Overloaded Network Upgrades
$102,060
Number of Constraints for 500MW Facility*
6
Planned Capacity at Substation (MW)
369 MW
Adjacent Acreage (1-mile radius)
1,999 acres
Buildable Acreage
1,747 acres
LMP Node (Nearest to Site)
CIN.LOGANOAKR-MISO-LMP
Avg. LMP, 5-Year Historical
$44.69/MWh
Avg. Solar-Weighted LMP, 5-Year Historical
$49.37/MWh
Avg. Top/Bottom 4-Hour Spread, 5-Year Historical
$33.88/MWh
Avg. LMP, 20-Year Forecast
$43.03/MWh
Avg. Solar-Weighted LMP, 20-Year Forecast
$37.02/MWh
Avg. Top/Bottom 4-Hour Spread, 20-Year Forecast
$35.17/MWh
Avg. PV RatedPower MWac per Parcel (MW)
15.30 MW
Avg. PV RatedPower MWac, Sum All Parcels (MW)
291.0 MW
$/MW to Upgrade Site for 122MW Facility
$147,835

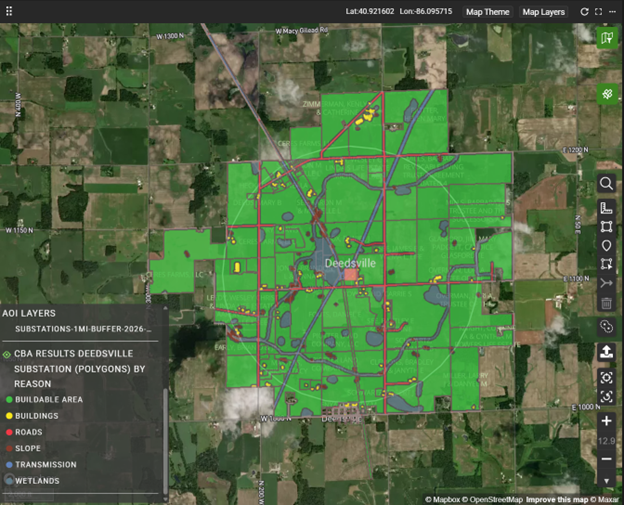

Opportunity Summary:

Deedsville presents the strongest combination of economics and land quality in the evaluated set. Network upgrade costs are the lowest at $188,100/MW across 6 constraints — a $450,000/MW advantage over Pike that translates to roughly $225M in savings at 500 MW scale. The surrounding Tipton Till Plain delivers a land position that is exceptional by any measure: 1,747 buildable acres at 89% buildability, with flat agricultural terrain, no karst geology, and minimal wetland exposure. Individual parcel sizes average 15.3 MWac, aggregating to ~291 MWac of modeled solar capacity across the buildable footprint. The reduction in project size to ~291MWac benefits the project by removing 2 of the constraints that appear at 500MW, reducing the network upgrade risk to $147,835/MW. The LMP environment is the strongest of the three sites at $44.69/MWh historically and $49.37/MWh solar-weighted, supported by a 20-year forward case that holds above $43/MWh. Miami County’s 2021 solar ordinance provides one of Indiana’s few unambiguous permitting pathways. The primary risk is queue competition: 369 MW of planned capacity at Deedsville demands early queue positioning and rigorous delivery study management.

Strengths

  • Lowest modelled upgrade costs with an estimated $188k per MW across 6 constraints at 500MW scale and $148k per MW across 4 constraints at the 291MW the available land can support.
  • Largest buildable land position in the evaluated set — 2,308 acres at 89% buildability, reflecting the flat, open agricultural character of the Tipton Till Plain
  • Highest modeled solar capacity (~291 MWac), enabling phased development or a single large-scale project at one interconnection point
  • 345 kV access at the Deedsville substation provides high-capacity transmission connectivity
  • No karst geology, no bat hibernacula — standard environmental due diligence without the show-stopper risks present in southern Indiana karst counties
  • Established 2021 solar ordinance creates a clear, predictable permitting pathway — a meaningful advantage in Indiana’s difficult regulatory environment
  • Strongest historical LMP ($45/MWh) among evaluated sites, supporting attractive merchant pricing
  • Highest solar-weighted LMP ($49/MWh), indicating above-average value during solar production hours

Challenges

  • Moderate planned competition (369 MW) at the Deedsville substation requires careful interconnection queue positioning and delivery study management

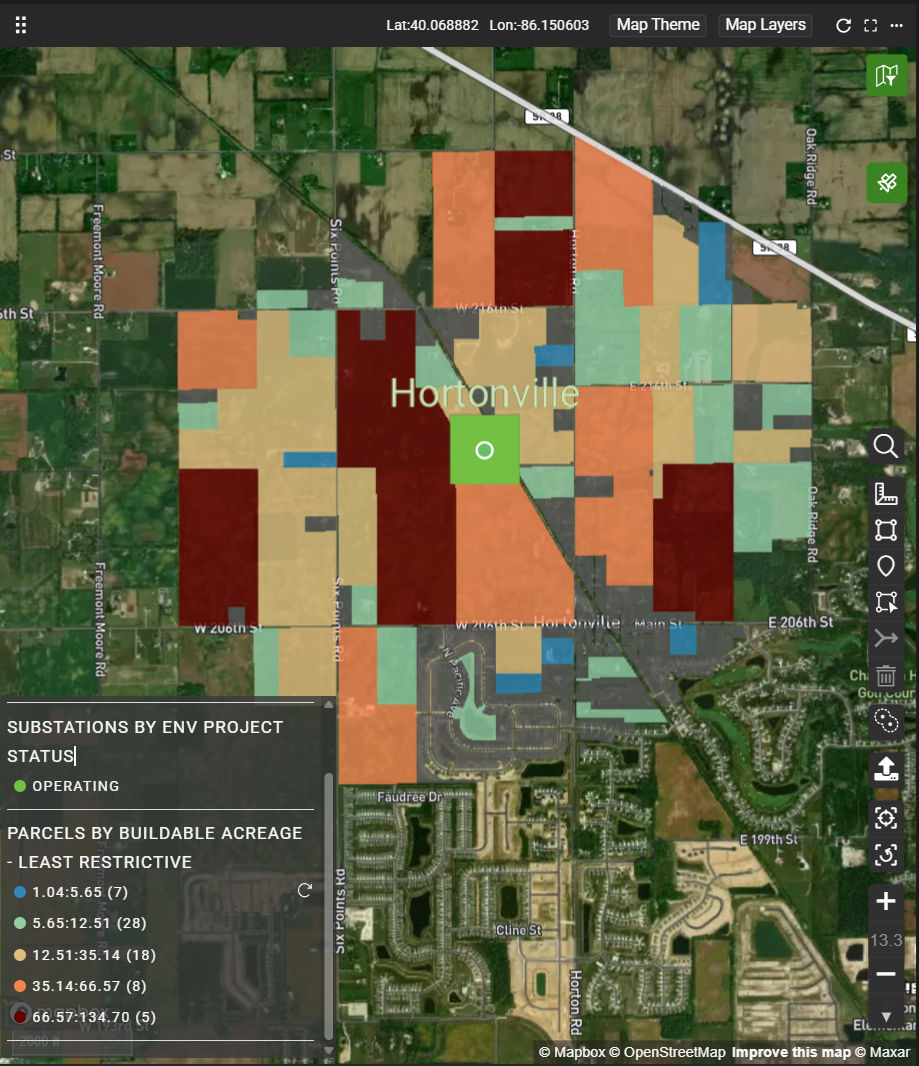

Project 3 – Vermillion County, Indiana

Attribute
Value
County
Vermillion
ISO
MISO
Nearest Substation
Cayuga City
Bus Voltage (kV)
345 kV
$/MW to Upgrade Site for 500MW Facility
$523,874
$/MW for Pre-Overloaded Network Upgrades
$475,204
$/MW for Newly-Overloaded Network Upgrades
$48,670
Number of Constraints for 500MW Facility*
8
Planned Capacity at Substation (MW)
0 MW
Adjacent Acreage (1-mile radius)
1,728 acres
Buildable Acreage
620 acres
LMP Node (Nearest to Site)
CIN.CT.VERMN.8-MISO-LMP
Avg. LMP, 5-Year Historical
$41.27/MWh
Avg. Solar-Weighted LMP, 5-Year Historical
$45.25/MWh
Avg. Top/Bottom 4-Hour Spread, 5-Year Historical
$29.26/MWh
Avg. LMP, 20-Year Forecast
$41.24/MWh
Avg. Solar-Weighted LMP, 20-Year Forecast
$35.21/MWh
Avg. Top/Bottom 4-Hour Spread, 20-Year Forecast
$34.61/MWh
Avg. PV RatedPower MWac per Parcel (MW)
5.90 MW
Avg. PV RatedPower MWac, Sum All Parcels (MW)
94.1 MW
$/MW to Upgrade Site for 122MW Facility
$2,786,568

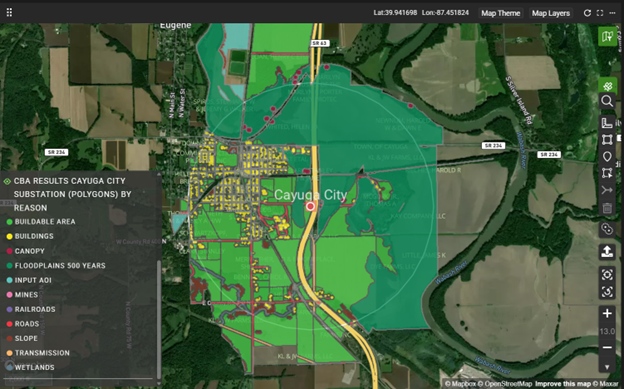

Opportunity Summary:

Cayuga City is purpose-built for storage forward or hybrid development. The substation carries a clean interconnection queue — zero planned competing generation, and the strongest intraday price spreads in the evaluated set: $29.26/MWh historically, rising to $34.61/MWh in the 20-year forward case. These spread dynamics directly support battery storage arbitrage economics and make Vermillion the natural home for developers optimizing around dispatch value rather than energy generation alone.

The site’s limitations are structural. At $523,874/MW across 8 binding constraints, the highest constraint count evaluated, network upgrade costs are meaningful, and complexity is elevated. The buildable land footprint at 620 acres supports only compact or storage-dominant configurations, not large-scale solar-only development, increasing the network upgrade risk to $2,786,568/MW. Regulatory risk is real: a solar moratorium was narrowly defeated in October 2025. Projects here require storage-heavy financing and close monitoring of the permitting environment.

Strengths

  • Zero planned competing generation at the substation, the cleanest interconnection queue in the evaluated set
  • Strong intraday price spreads ($36/MWh historical), the highest among evaluated sites, directly supporting storage arbitrage value
  • Multiple large-scale projects in the county actively in permitting (Oriden ~185 MW, Apex ~200 MW), confirming the development pathway exists

Challenges

  • Fairly high upgrade costs in comparison to other sites at $523k per MW to upgrade the point of interconnection for a 500 MW asset and nearly $2.8M per MW for the 94MW facility that the available land can support.
  • Smaller buildable land footprint (~746 acres) favors compact or storage-dominant configurations over large-scale solar-only projects
  • Political environment in flux: a solar moratorium was narrowly defeated (October 2025)
  • Development profile requires storage-heavy or hybrid financing and offtake structures, increasing transaction complexity

Side-by-side Comparison

1. Interconnection Economics

Metric
Pike
Miami
Vermillion
$/MW Upgrade (500 MW)
$638,721
$188,100
$523,874
# Constraints
6
6
8
Planned Competing (MW)
100 MW
369 MW
0 MW

2. Land Availability

Metric
Pike
Miami
Vermillion
Adjacent Acreage (1-mi)
1,890 ac
1,999 ac
1,728 ac
Buildable Acreage
717 ac
1,747 ac
620 ac
% Buildable
37.9%
87.4%
35.9%
Est. Total Solar MWac
~122 MW
~291 MW
~94 MW

3. Pricing & Storage Value

Metric
Pike
Miami
Vermillion
Avg. LMP, 5yr Historical
$42.91/MWh
$44.69/MWh
$41.27/MWh
Solar-Wtd LMP, 5yr Historical
$47.41/MWh
$49.37/MWh
$45.25/MWh
4-Hr Spread, 5yr Historical
$30.48/MWh
$33.88/MWh
$29.26/MWh
Avg. LMP, 20yr Forecast
$43.13/MWh
$43.03/MWh
$41.24/MWh
Solar-Wtd LMP, 20yr Forecast
$38.53/MWh
$37.02/MWh
$35.21/MWh
4-Hr Spread, 20yr Forecast
$31.32/MWh
$35.17/MWh
$34.61/MWh

Recommendation

Best Overall Site

Project 2 (P2): Deedsville Substation – Miami County, Indiana

Why Miami County Leads

  • Strongest economics in the evaluated set.
  • At $188,100/MW across 6 constraints for 500MW and $147,835/MW across 4 constraints for the 291MW’s that can be supported with available land; network upgrade costs are less than one-third of Pike’s and save approximately $225M at 500 MW scale.
  • The 1,747 buildable acres at 89% buildability is the largest and highest-quality land position evaluated, and the LMP environment is the best of the three sites at $44.69/MWh historical and $49.37/MWh solar-weighted.
  • Miami County’s permissive 2021 solar ordinance removes the regulatory uncertainty that defines muchof Indiana’s development landscape.
  • The queue competition at 369 MW is the primary execution risk; early interconnection filing and delivery study positioning are essential.
